PROJECT UPDATE
(4.11.2012):
We
are 30-45 days from completion. Interior finishing continues and the exterior
skin is past the half-way point.
The
PAINTERS have finish coated the ceilings and are meticulously prepping for the
final finish coat that will be done at the very end of the project. Wood doors
have also been finished and ready to hang.
The
CARPENTERS have been alternating between exterior and interior finishing. The
rear façade is 98% complete and they have just started “skinning” of the Davis
Street elevation.
The
HARDWOOD FLOORS have been installed and sanding/finishing will start next
week.
CABINETS
and COUNTERTOPS have been installed. CERAMIC TILE is also nearly
complete.
The
HVAC work is at the 85% point. Most of the ductwork has been hung and the
furnaces installed. The AC condensers will follow.
The
ELECTRICIANS have installed the light track and surface mounted fixtures. The
wiring of the HVAC system and exterior lighting will follow.
The
PLUMBERS start installing the water heaters, fixtures and trim in the next day
or so.
NEXT…EXTERIOR
CONCRETE (rear parking area and front entry), ORNAMENTAL IRON (unit 5 balcony and
exterior stair) and enter the clean phase of the project. Carpet and paint at
the very end… completion should be mid-MAY.
ANDY
(enjoy
the photos & video)
PAINTERS: lukacz & raphe remove dust a spot prime touch ups prior to applying 1st finished coat of paint. |
PAINTERS: low VOC polyurethane is used on “natural” door finish. this requires 3 coats whereas oil
based products require 2.
|
PAINTERS: prior to 2nd paint coat, walls are illuminated
and imperfections are touched up.
|
EXTERIOR SKIN: aluminum panels with backer.
|
EXTERIOR SKIN: 1/8” aluminum panels with .032 aluminum backer.
|
EXTERIOR SKIN: the addition is nearly complete, the same panels will “wrap
up” theadjacent vertical surface.
|
HARDWOOD FLOOR: working out the details.
|

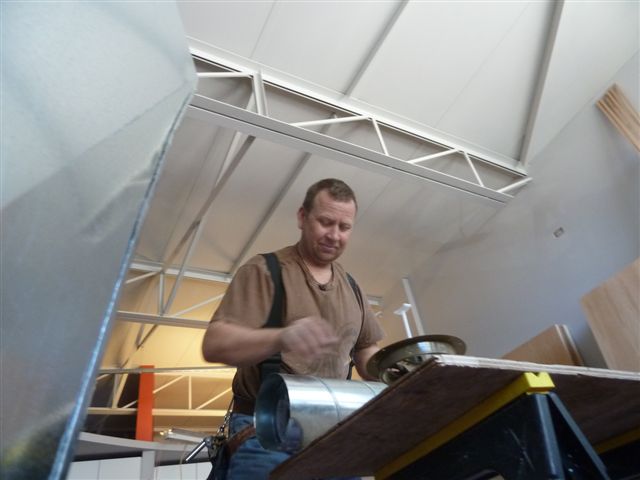

HVAC: igor is starting the exposed duct work. since it’s exposed,
it becomes a finished item and is done during the finishing
phase of the project.
|
HVAC: duct is hung from a single centered threaded rod/fender
washer system. thisgives us a minimal aesthetic.
|
HVAC: ductwork is hung, awaiting diffusers.
|
HVAC: gas furnace being installed. condenser piping being
soldered.
|
HVAC: igor is installing bathroom exhaust duct.
|
ELECTRICAL: sergei is installing surface mounted fixtures.
|
EXTERIOR SKIN: 1/8” aluminum panels “wrap” up from the underside
ultimately giving us a very
“slick” look.
|
EXTERIOR SKIN: .032 painted standing seam panels are also used.
|
EXTERIOR SKIN: rear addition looking east.
|
EXTERIOR SKIN: .032 aluminum fascia is installed after the panels are in
place.
|
CERAMIC TILE: freddie is working on unit 5’s shower.
|
CARPENTERS: unit 5 kitchen light track support is being hung from the
same threaded rod that supports the duct above.
|
CARPENTERS: casey is cutting floor base for unit 4. 2 ¾” pre-finished
ranch casing is used. the rounded bottom edge
allows us to use a one piece system cutting our labor cost in half.
|
CARPENTERS: kris is installing cove trim on hardwood window seat.
|
MATT: getting organized. Notice that the kitchen cabinets have also been
installed.
|
GRANITE COUNTERTOPS: granite was used on this project
at about the same cost as if we fabricated
MDF/plastic laminate tops on site…betterproduct/same $.
|
GRANITE COUNTERTOPS: matt makes sure we get right.
|
CERAMIC TILE: freddie is finishing up the kitchen
backsplashes.
|
EXTERIOR SKIN: rear addition. DONE. exit
stair on right to follow (see model pic below).
|
MODEL: rear addition, south elevation.
|
